Dholera International Airport is a greenfield airport being built for the Dholera Special Investment Region, about 20 km from the SIR and about 80 km from Ahmedabad. It is owned by a special purpose vehicle, Dholera International Airport Company Ltd (DIACL), split between the Airports Authority of India (51%), the Gujarat government (33%) and NICDC (16%). Phase 1 has a single 3,200 m Code 4E runway. As of mid-July 2026 the opening is a slipping target, not a fact: the original December 2025 date was missed, and a July 2026 report cited works about 80% complete with operations aimed at September to October 2026. No firm opening has been confirmed.
Dholera International Airport is a greenfield airport under construction to serve the Dholera Special Investment Region, sitting about 20 km from the SIR and about 80 km from Ahmedabad. It is being delivered through a dedicated special purpose vehicle and is planned to open in Phase 1 with a single 3,200 m runway rated Code 4E, the category that accommodates wide-body aircraft. The single most searched question is when it opens, and the honest answer in mid-2026 is that the opening is a target that has moved more than once, so we do not state a firm date as fact on this page.
Dholerapedia is an independent, neutral reference. We do not sell plots and we do not promote any airline, contractor or developer. Every number below is tagged as durable or reported, and where the record is a target rather than an achievement, we say so plainly.
Who is building it and who owns it
The airport is owned and developed by a special purpose vehicle called Dholera International Airport Company Ltd, usually shortened to DIACL. The equity is shared between three public bodies, which is a common structure for infrastructure of this scale in India. The Airports Authority of India (AAI) holds the majority stake, the Gujarat government holds the second largest share, and NICDC, the central agency that steers India's industrial corridors, holds the remainder. The Gujarat Airports Company (GACL) is often cited in connection with the operating role.
This three-way public ownership matters for context. It ties the airport to the same corridor programme that anchors Dholera as a whole, and it means progress tends to track central and state infrastructure schedules rather than a single private developer. For the wider picture of how the region is governed and phased, see what is Dholera SIR.
The runway and Phase 1 design
Phase 1 is built around one runway of 3,200 m, classified as ICAO aerodrome reference Code 4E. In plain terms, that length and code are enough for large aircraft including many wide-body types, which is consistent with the international designation. The airport is positioned to serve both the industrial base being built inside the SIR, including the Tata semiconductor fab, and the broader south-of-Ahmedabad catchment.

The main contracts
Two contract figures are on the public record and are worth stating precisely, because they are the kind of numbers that get inflated in marketing. The Phase 1 civil works were awarded to Varaha Infrastructure at a reported value of about Rs 636.45 crore. A separate terminal building EPC contract was reported at about Rs 333 crore around January 2024. The total consolidated project cost is not reliably sourced, so we do not publish a single headline figure for the whole airport.
| Item | Reported value | Note |
|---|---|---|
| Phase 1 civil works | ~Rs 636.45 cr | Awarded to Varaha Infrastructure |
| Terminal building (EPC) | ~Rs 333 cr | Reported around January 2024 |
| Total project cost | Not reliably sourced | No single verified figure published |
Distance and how it connects
The airport sits about 20 km from the Dholera SIR and about 80 km from Ahmedabad. That places it closer to the industrial region it primarily serves than to the city, which is the point of a dedicated corridor airport. Road access improved sharply once the Ahmedabad-Dholera Expressway opened, and a planned semi-high-speed rail link would add a second fast route over time. For the door-to-door picture from the city, see Ahmedabad to Dholera distance.
Status and the opening timeline

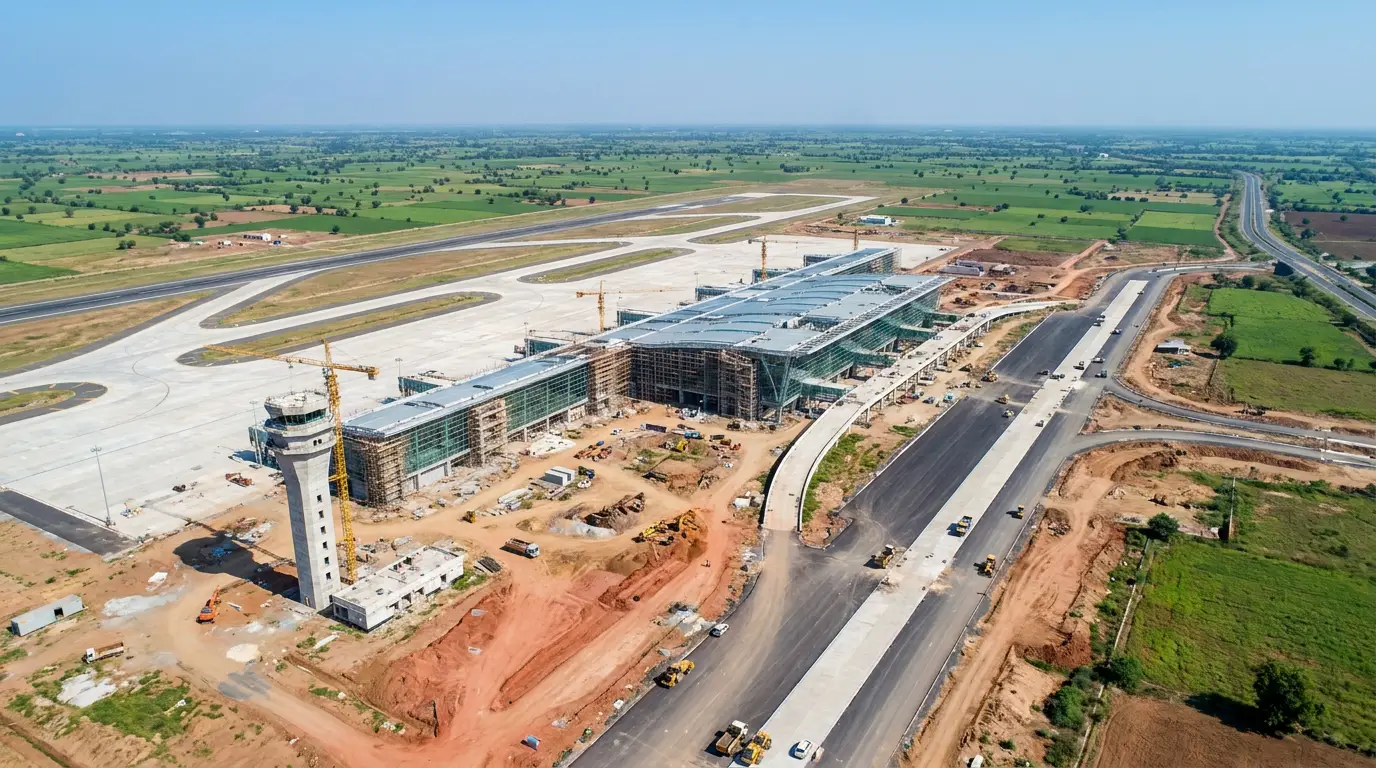

This is where care matters most. An airport opening at Dholera has been a recurring, slipping target for years, so any single date should be read as an aim rather than a promise. The original target of December 2025 was missed. Reference sources such as Wikipedia have listed a December 2026 date. As of 14 July 2026, the Union Aviation Minister was reported to have said the works were about 80% complete, with operations likely in September to October 2026. These are reported targets from July 2026, and no source confirms the airport is operating.
The pattern of slipping dates is not unusual for greenfield airports of this size, and it does not by itself indicate the project has stalled. Physical progress has clearly continued, from civil works to the terminal build. The reasonable reading in mid-2026 is that the airport is well advanced but not yet open, and that the safest assumption for any plan or purchase is to treat commissioning as pending.
Why the airport matters for the region
For Dholera, the airport is one of three connectivity anchors, alongside the expressway and the proposed rail link. Together they are meant to turn a coastal industrial zone into somewhere goods and people can reach quickly. If you are weighing the region as a whole, the airport should be counted as a strong-but-unfinished positive rather than a live asset, and its timeline risk should be factored in. Our neutral guide on whether Dholera is safe to invest in treats these anchors the same careful way.
Frequently asked questions
When will Dholera International Airport open?
Who owns Dholera International Airport?
How far is the airport from Ahmedabad and from Dholera SIR?
How long is the runway?
What are the main construction contracts?
Is the airport operational yet?
Dholerapedia. (2026). Dholera International Airport: Status, Runway and Timeline. Retrieved 16 July 2026, from https://dholerapedia.com/dholera-airport.htmlSources & references
- Dholerapedia fact pack, 2026 (DIACL ownership AAI 51 / Gujarat 33 / NICDC 16; runway 3,200 m Code 4E; ~20 km from SIR, ~80 km from Ahmedabad)
- Reported contract values: Varaha Infrastructure Phase 1 civil works ~Rs 636.45 cr; terminal EPC ~Rs 333 cr (Jan 2024)
- Reported status, 14 July 2026: Union Aviation Minister cited works ~80% complete, operations likely Sept to Oct 2026 (target)
- Reference listing of a December 2026 date (en.wikipedia.org, Dholera International Airport)
- Dholerapedia pillar pages: what is Dholera SIR, Ahmedabad-Dholera Expressway, Dholera rail connectivity, Dholera semiconductor fab
Dholerapedia labels facts by confidence. Figures marked reported or target come from press or announcements and may change; verify anything time sensitive against the official source before acting.
